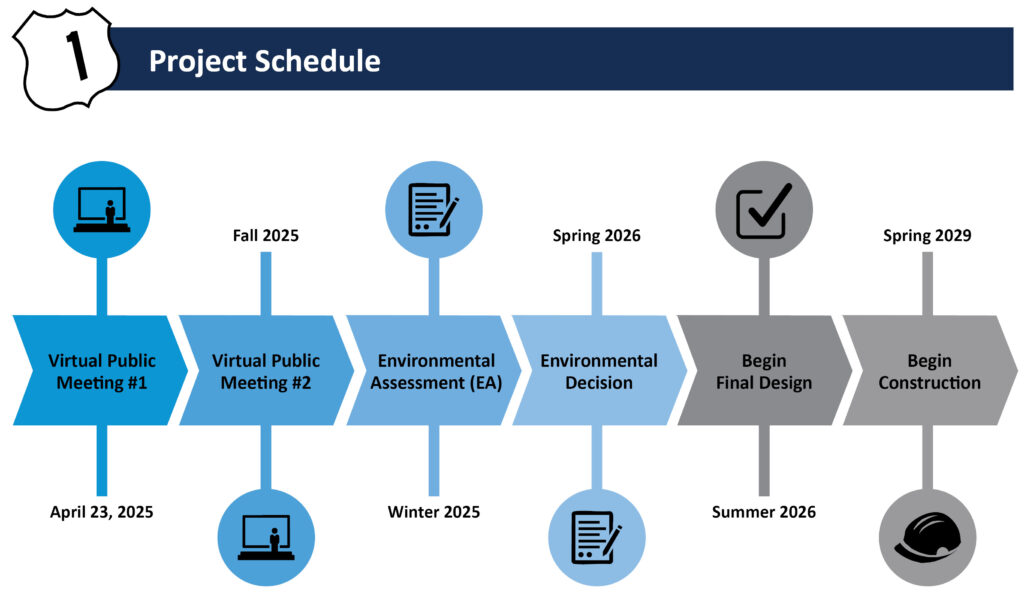

The National Environmental Policy Act (NEPA) requires projects involving a federal action to be evaluated for potential environmental impacts. The NEPA process is followed during the preliminary design/environmental studies stage of a project. Section RC3 is currently being evaluated in an Environmental Assessment (EA) Document.

The EA analyzed potential environmental impacts associated with the proposed transportation improvements pursuant to the requirements of the National Environmental Policy Act (NEPA) of 1969. The EA analyzed two alternatives, the Build Alternative and the No Build Alternative, and presented the potential impacts to various natural, cultural and community resources located within the project area and the proposed mitigation to offset those impacts. The Build Alternative, which meets the project needs while minimizing environmental impacts and addressing public and agency feedback, has been identified as the Preferred Alternative.

Sections RC1 & RC2 Environmental Documentation

The National Environmental Policy Act (NEPA) requires projects involving a federal action to be evaluated for potential environmental impacts. The NEPA process is followed during the preliminary design/environmental studies stage of a project. RC1 and RC2 were evaluated together in a Level 2 Categorical Exclusion Evaluation (CEE).

Section RC1 and Section RC2 Environmental Document

A Level 1B CEE was completed for the U.S. 1, Section RC1 and Section RC2 project in 2006. Based on changes to the design of the project, this CEE document required revisions to accurately depict the impacts to the natural and built environments, which resulted in the completion of a Level 2 CEE re-evaluation in 2016/2017.  The Level 2 CEE re-evaluation document was approved in 2017 and can be found by clicking on the following link here.

Section RC1 and Section RC2 Wetland Mitigation Sites

Wetlands – Six wetlands were identified and delineated within the project corridor by PennDOT’s consultant. Four of the wetlands were characterized as forested wetlands and the remaining two were identified as wetlands dominated by emergent vegetation. Wetlands ranged in size from 0.01 to 0.16 acres in size.

Streams – The Neshaminy Creek is a major perennial watercourse that flows from west to east through the northern portion of the U.S. 1 project corridor. The Neshaminy Creek is classified as a Warm Water Fishery (WWF) with an average water depth of three feet and an average stream width of 216 feet.

Project alternatives were identified and developed to avoid and minimize impacts to the wetlands and streams within the U.S. 1 project corridor, sections RC1 and RC2.  Unavoidable impacts require mitigation through the replacement of wetland and stream resources. PennDOT identified two mitigation sites to offset impacts to wetlands and streams as a result of the U.S. 1, Sections RC1 and RC2 improvements. One On-site Mitigation area located off Street Road and one Off-site Mitigation site located at Bensalem High School.

Section RC1 and Section RC2 Noise Study

A Type I preliminary design noise study was conducted and a Draft Technical Noise Report prepared for the U.S. 1, Section RC1 and RC2 Project, to determine if noise abatement measures would be warranted. For abatement measures deemed to be warranted, a further analysis was performed to determine whether these measures would be feasible and reasonable according to PENNDOT and Federal Highway Administration (FHWA) Noise Abatement Criteria (NAC) that depends on the existing land use activity. The preliminary design noise study analysis received concurrence by the FHWA in May 2013.

Section RC1 identified the need for a Noise Barrier in the vicinity of Roosevelt Cemetery. In 2013, PennDOT held a Noise Barrier specific meeting with the affected property. The meeting was held to share the results of the final design noise analysis, indicate proposed locations of sound barriers, and to gather the preference for having the barriers built and the preferred finish on the community side of the barriers.

Representatives of PennDOT and their design team held a meeting with impacted and benefited homeowners of the Old Lincoln Highway neighborhood within the RC2 project corridor, on October 3, 2018, to discuss preliminary noise analysis findings and the preliminary proposed noise barrier. The team discussed mitigation measures associated with constructing a sound barrier near residences and options for lower noise levels adjacent to S.R. 0001 Southbound. The team requested the input of the applicable property owners using a Noise Barrier Preference Survey form. Community members submitted their completed Noise Barrier Preference Survey forms, and the tallied votes show support for the construction of the noise barrier.

Section RC3 Environmental Assessment Documentation
  • Environmental Assessment Document (Coming Soon)
  • Project Technical File
  • Provide Comments on Environmental Assessment Document (Coming Soon)
  • Sign Up to Provide Testimony at the Public Hearing (Coming Soon)
